enable Case studies

Case study · Lift & Fix · Two projects

Two occupied towers. We took the load off, rebuilt the columns, and put it back.

Two 18-storey apartment buildings in Ontario, each standing on failing columns, each full of residents. In Hamilton we carried the building around the damaged columns in steel. In Toronto we carried it through the column itself: 1,000,000 lb, monitored every second and streamed live. Nobody had to move out.

201 Jackson
250 Heath Street
Location
Hamilton, ON
Toronto, ON
Load path
Around the column
Through the column
Consultant
Sigmund Soudack & Associates
Davroc & Associates Ltd.
General contractor
Conterra Restoration, both projects
Follow the load ↓
201 JACKSON 250 HEATH 3 LEVELS GRADE P1 REPAIR 18 STOREYS OCCUPIED AROUND THE COLUMN HAMILTON · 2023–24 THROUGH THE COLUMN TORONTO · 2025
Roof to the baseBoth towers

18 occupied storeys, twice.

Both buildings are 18-storey reinforced concrete apartment towers, and both stayed full while we worked. Residents were home and every floor carried its normal load. Both jobs were for Conterra Restoration, and both repairs had to fit around the people living above.

The columnsBoth towers

Where the load path was failing.

201 Jackson · Hamilton Concrete separating from the base columns in sheets up to 4 in. thick, along their full height. Risk rated extreme.
250 Heath · Toronto Chloride contamination had badly corroded the main vertical bars in a column at the P1 garage level.

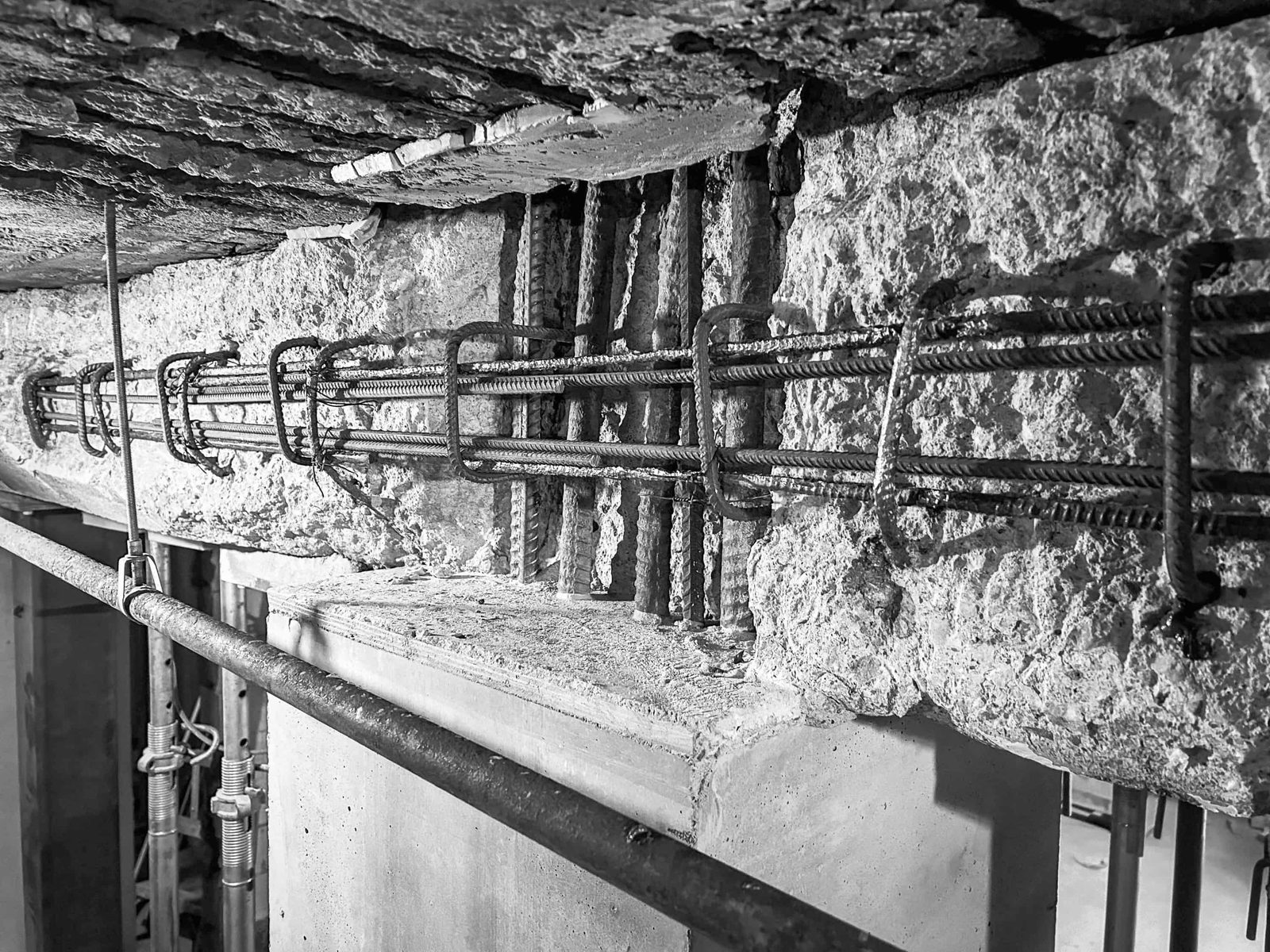

Badly deteriorated concrete with the reinforcing cage exposed
Deterioration exposed at 201 Jackson once the loose concrete came off

The usual fix doesn't take the load off.

Garage columns get full repairs all the time, because the slab above is easy to shore. Building columns usually don't. The standard approach is to remove the loose concrete and cast a jacket around what's left. The jacket protects the steel, but it doesn't share the load. The damaged column keeps carrying the building.

Both times, we took the load off instead. We just found a better way to do it the second time.

201 JacksonPath 1 · Around the column
201 JacksonHamilton, ON · 2023–24

Path 1: around the column, in steel.

Three levels of heavy steel shoring frames, designed to carry the full weight of the structure above each column. Hydraulic cylinders built into the frames moved the load off the damaged columns slowly, in stages.

The lowest level bears over the building's strip footing, where all of the load ends up. It was the hardest installation on the job.

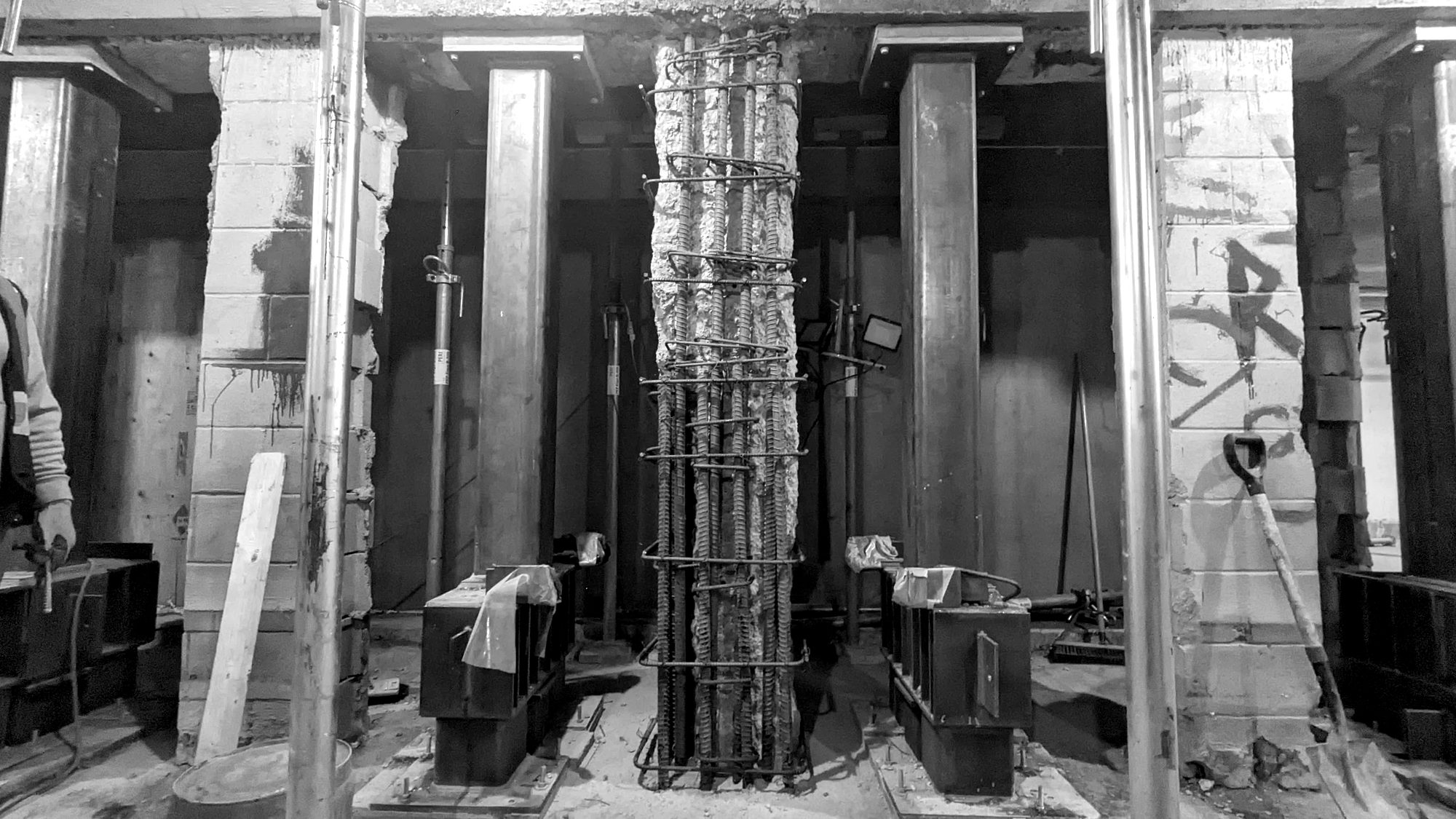

Damaged column stripped to its reinforcing cage, standing between two steel shoring posts on anchored bases
  1. Steel shoring postCarries the building past the column under repair.
  2. Existing columnStripped back to the reinforcing cage.
  3. Anchored post baseGrouted and bolted, with the hydraulics below.
Fig. 1 · 201 Jackson: the load goes around the column

A custom data acquisition system read strain through the frames in real time. As load came off and went back on, the team could see it and adjust, step by step.

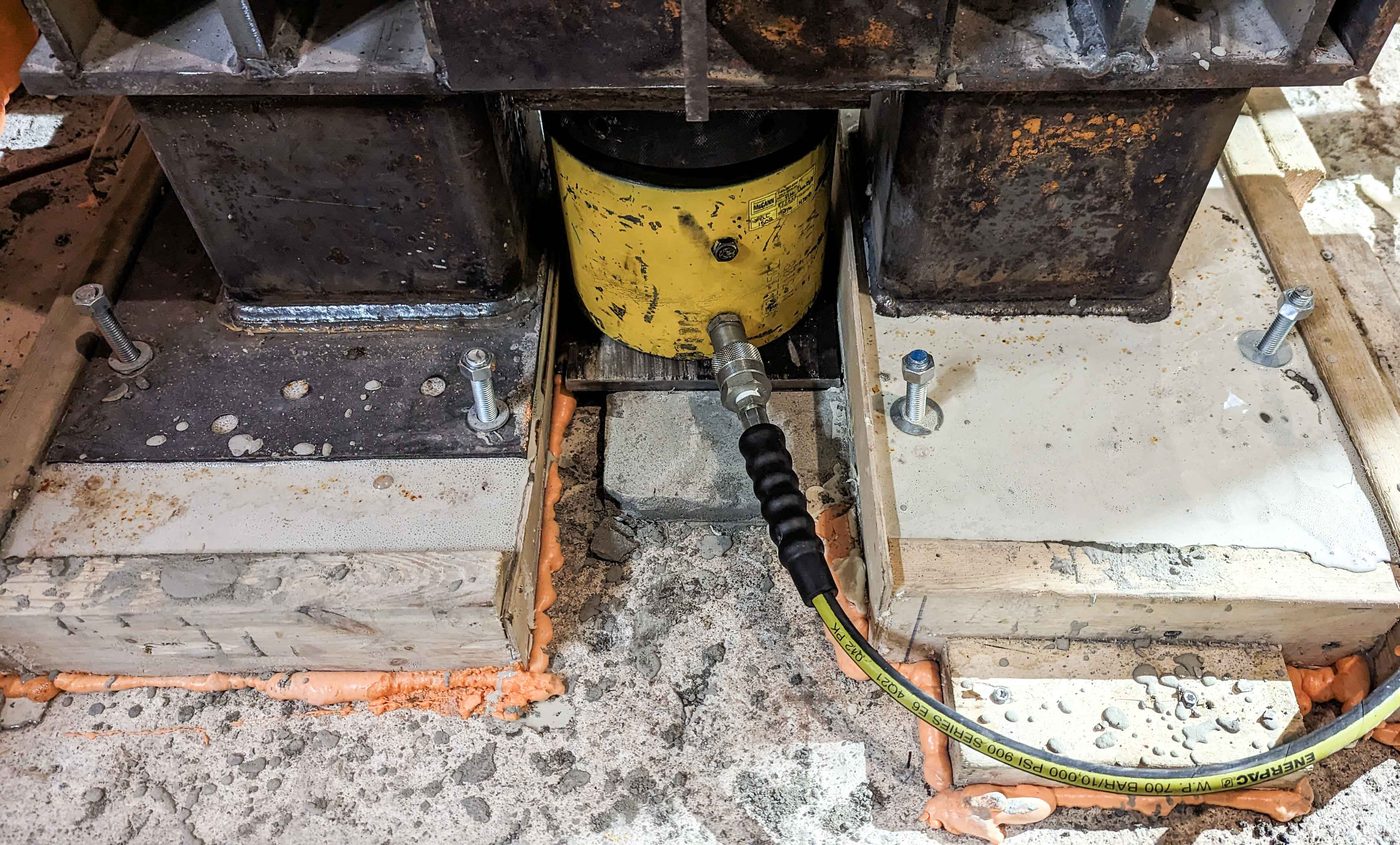

Yellow hydraulic cylinder set between two anchored steel post bases
Cylinder under the frame

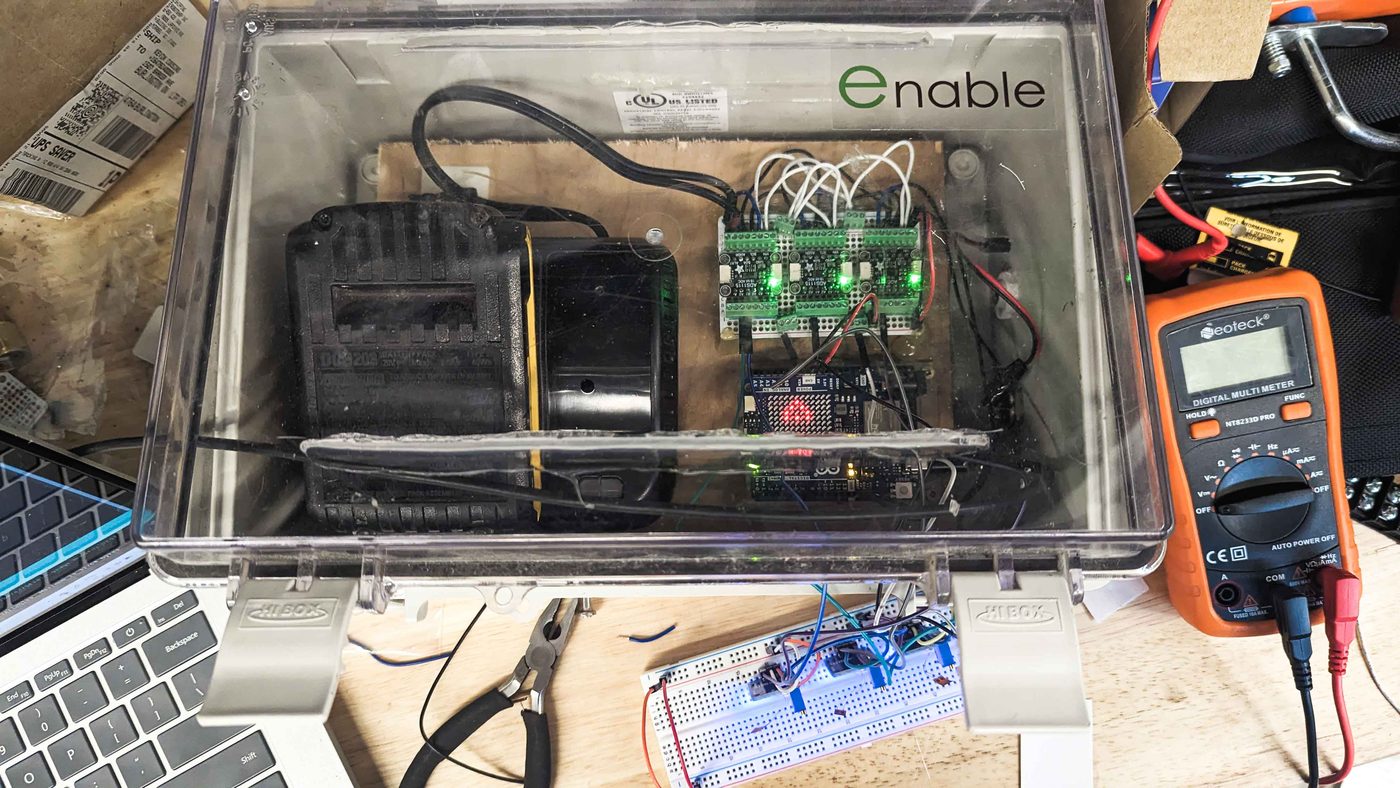

Open enclosure with Enable-built data acquisition boards and a multimeter
Enable-built data acquisition

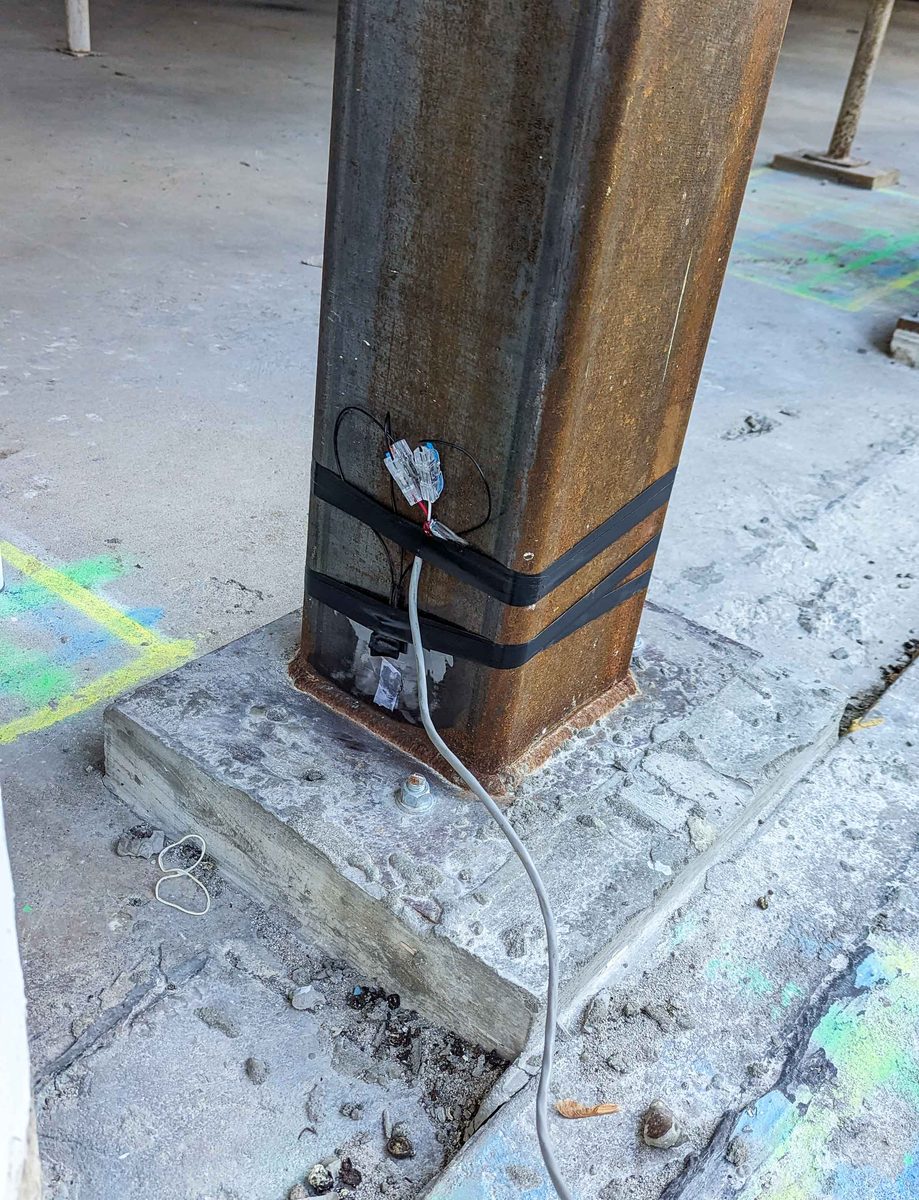

Strain gauge bonded to the flange of a steel shoring post near its base
Strain gauge on a post
201 JacksonRepair and return

Rebuild, then give the load back.

With the building on the steel, Conterra Restoration's crews cut the columns back to the reinforcing cage, formed them and re-poured. The load then came off the steel and back onto new concrete, under the same live monitoring.

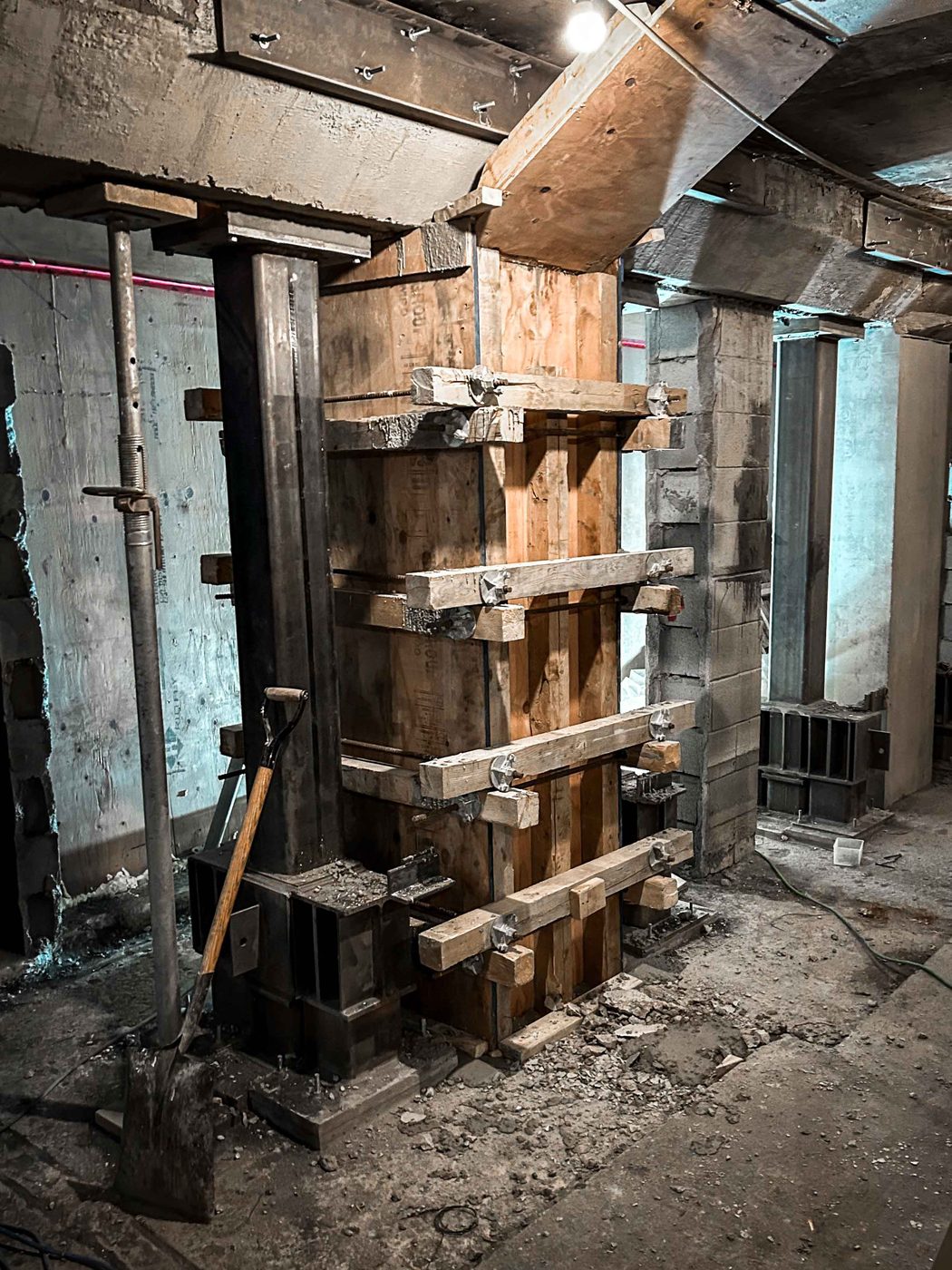

Timber formwork clamped around a column between steel shoring posts
Formed

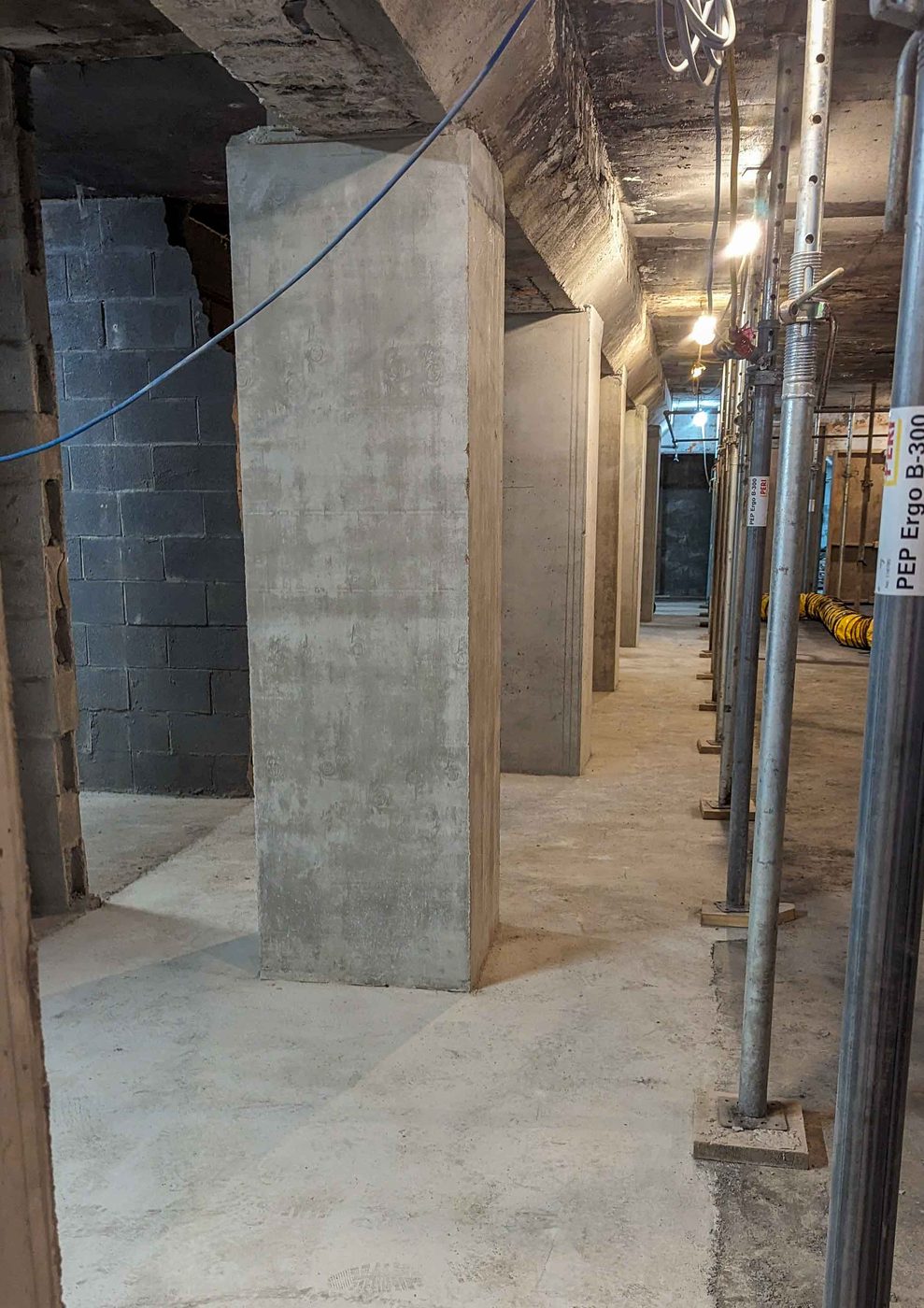

New smooth concrete columns in a parking level corridor
Rebuilt, March 2024
2023 → 2025What changed

Then we moved the load path inside the column.

At Jackson, the shoring carried the load from the slab down to the footing. At Heath, we kept the load in the column and bypassed only the section that needed repair: bracket to bracket.

2023 · 201 Jackson Around the column Steel shoring from the slab above down to the strip footing. Three levels of frames.
2025 · 250 Heath Through the column Brackets bolted through the column itself, above and below the damage. Only the repair zone is unloaded.
250 HeathPath 2 · Through the column
250 Heath StreetToronto, ON · 2025

Path 2: bracket to bracket, through the column.

Steel brackets went in above and below the repair zone, each bolted through the column with six 2-in. high-strength alloy bolts grouted into the concrete. Four hydraulic load points between the brackets carried the building around the repair zone, leaving the concrete in between free to come out.

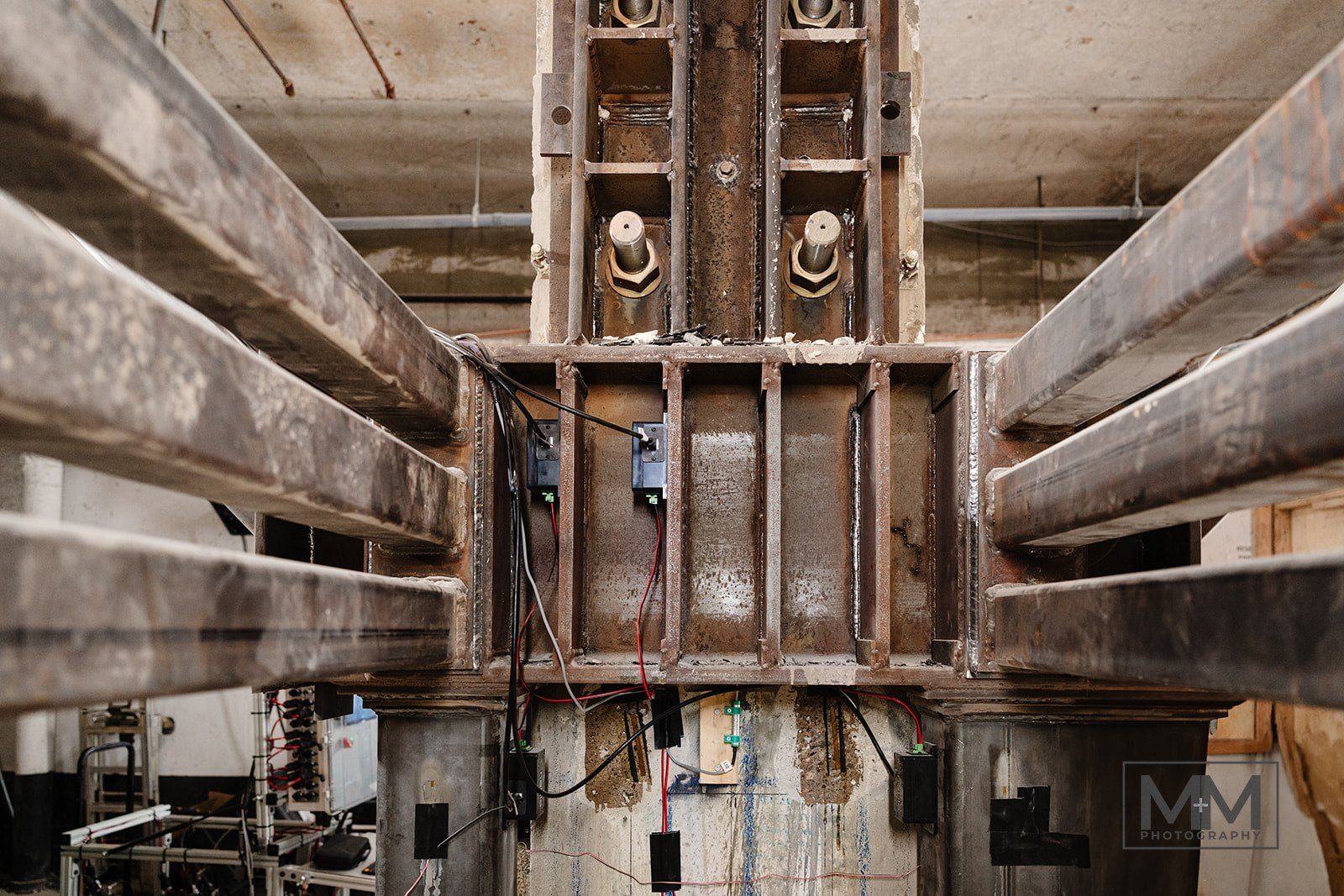

Looking up at the steel bracket assembly wrapped around the column, with diagonal braces and stiffened plates
The bracket assembly at P1, 250 Heath Street
3/16 in. bolt tolerance for every bracket to fit

The hardest part came before any jacking. Each bolt sat in a cored hole larger than the bolt itself, yet had to land within 3/16 of an inch or the brackets wouldn't fit over them. We designed, tested and used custom grout manifolds. Each one held its bolt in exact position, sealed against the column face, and directed pumped grout around the bolt. Every bracket fit.

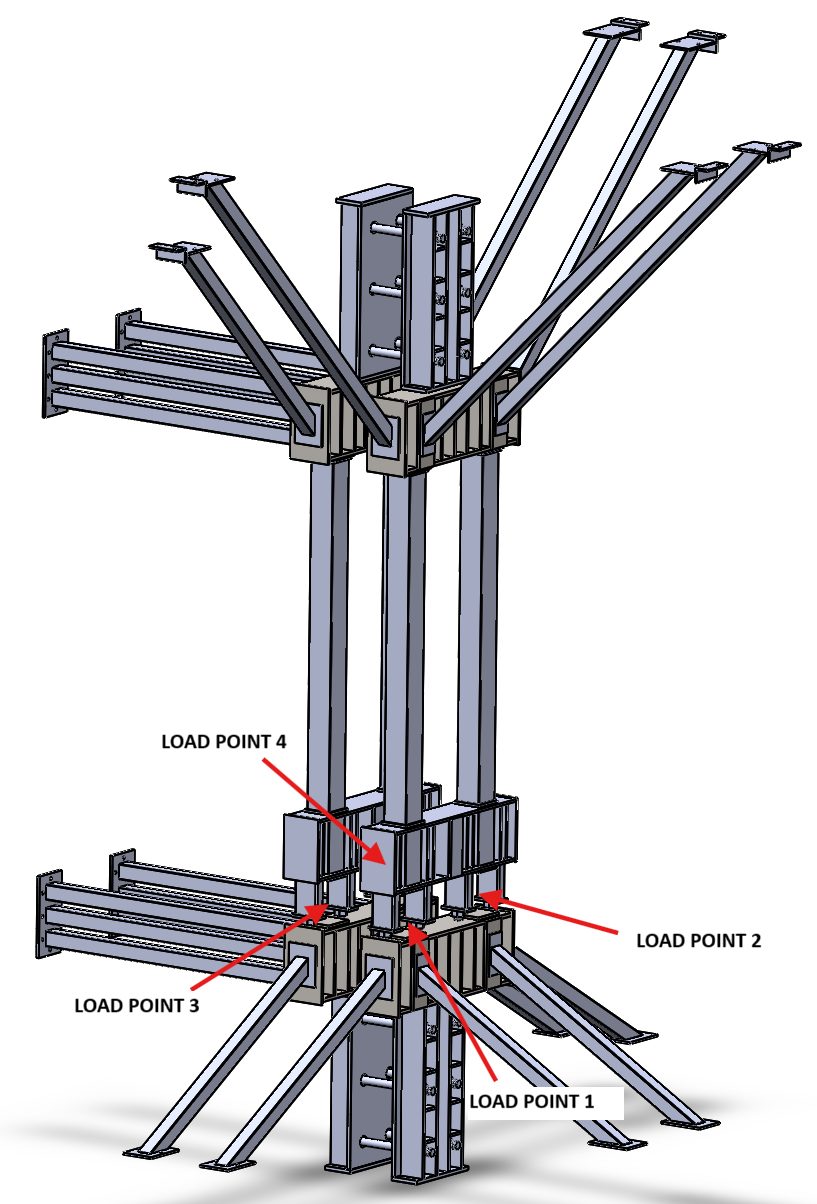

3D model of the column with upper and lower brackets, four posts and load points 1 to 4 marked in red
Designed: load points 1 to 4

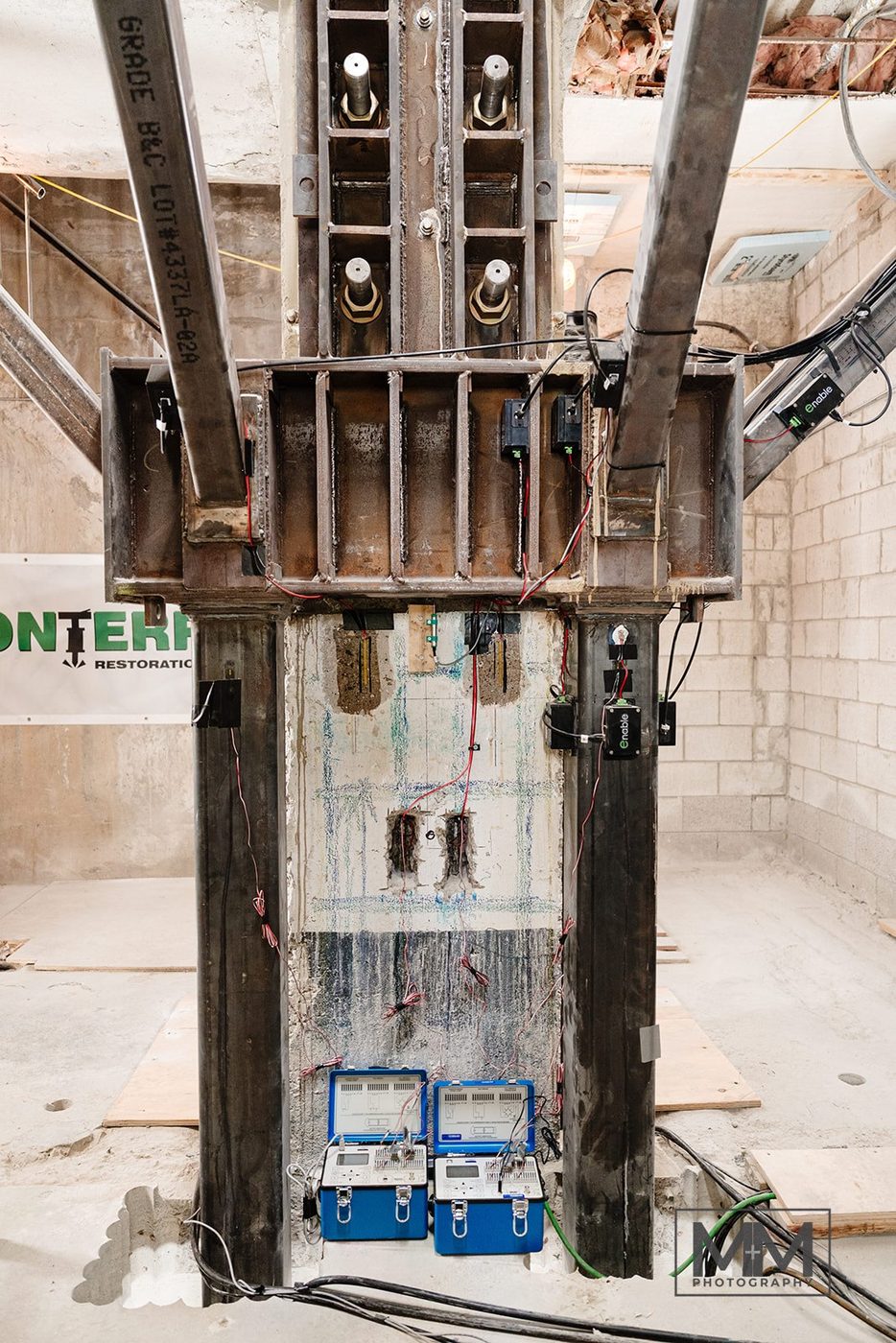

The installed bracket assembly on the column, with hydraulic connections at the base
Installed
250 HeathThe lift

A million pounds off, in three stages.

1,000,000 lb taken off a single column, across four load points

We designed and built the hydraulic control system ourselves: custom valving, CNC-machined valve manifolds, pressure transducers, load cells and embedded microcontrollers regulating pressure and flow on every circuit.

Load transferred off the column
Stage 1 · Apr 1533%
Stage 2 · Apr 1667%
Stage 3 · Apr 17100%

Each stage held until the data showed the transfer was stable. Only then did demolition begin.

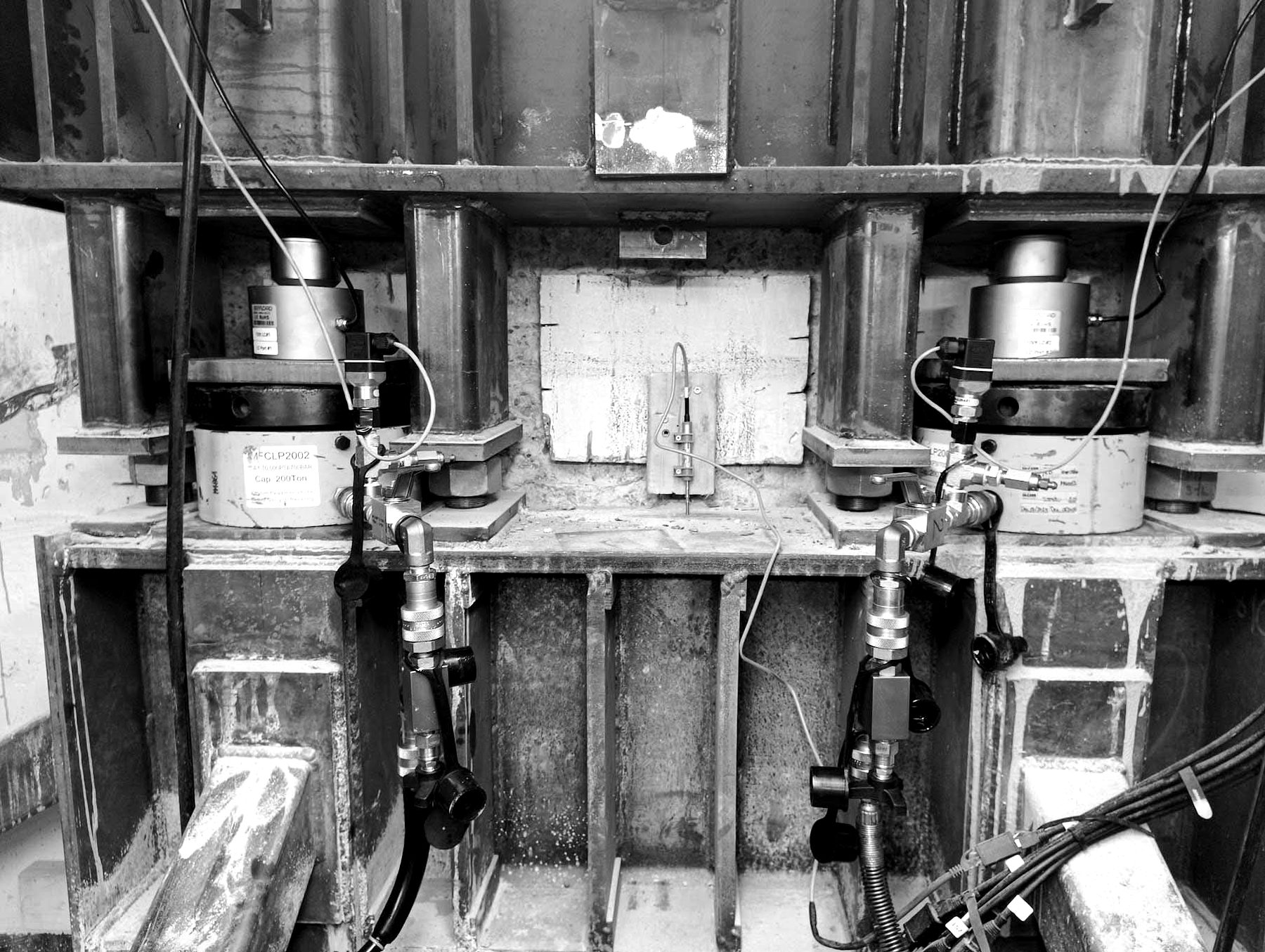

Two hydraulic cylinders with load cells on top, sitting on the stiffened lower bracket, with a displacement sensor on the column face between them
  1. Load cellReads the load at each point, every second.
  2. Hydraulic cylinderOne of four load points, each on its own circuit.
  3. Pressure transducerCircuit pressure, fed back to the controller.
  4. Position sensorTracks bracket movement against the column.
  5. Lower bracketBolted through the column below the repair zone.
Fig. 2 · 250 Heath: two of the four load points

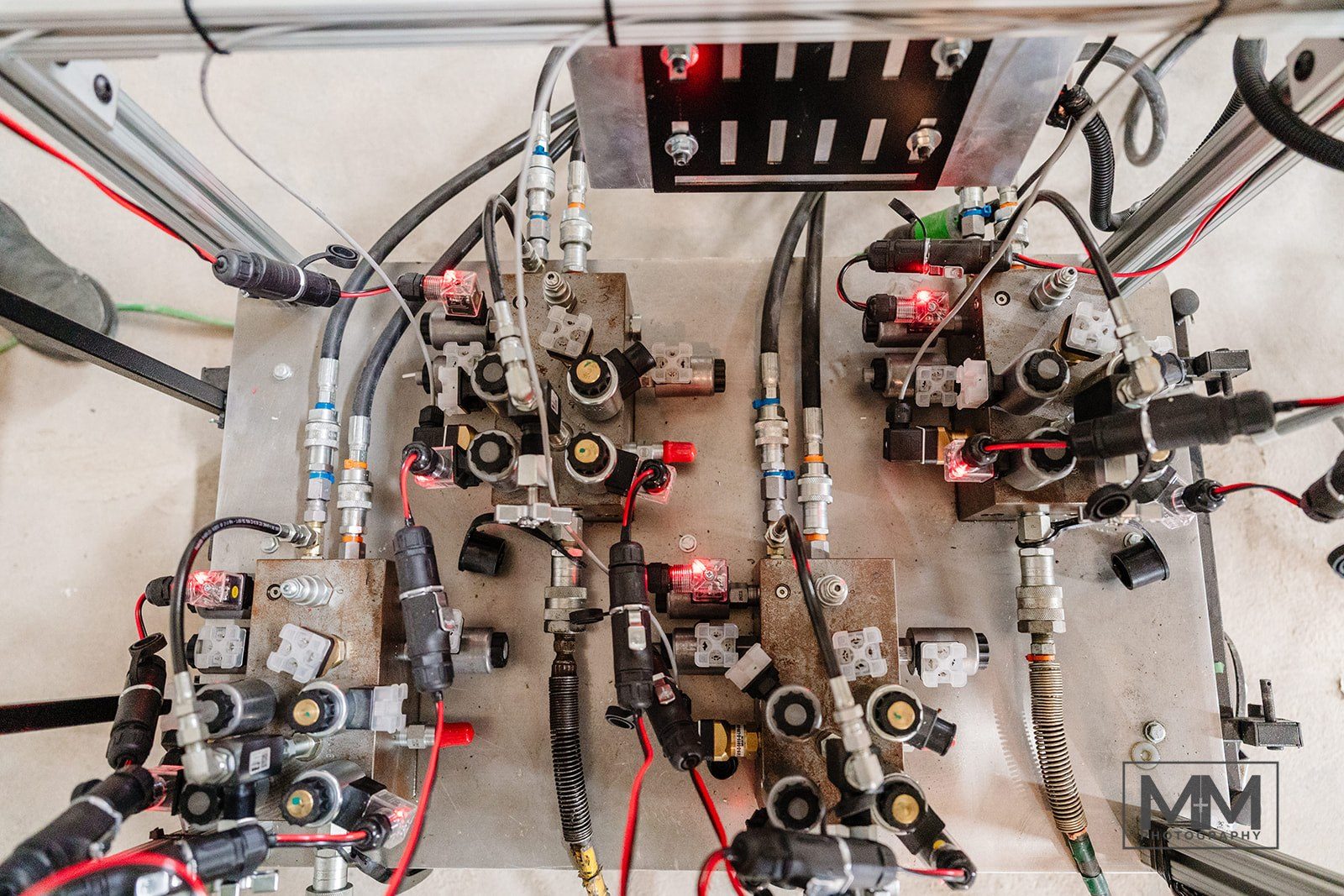

Hydraulic valve manifolds with solenoid valves and hoses on a mounting panel
Custom valve manifolds

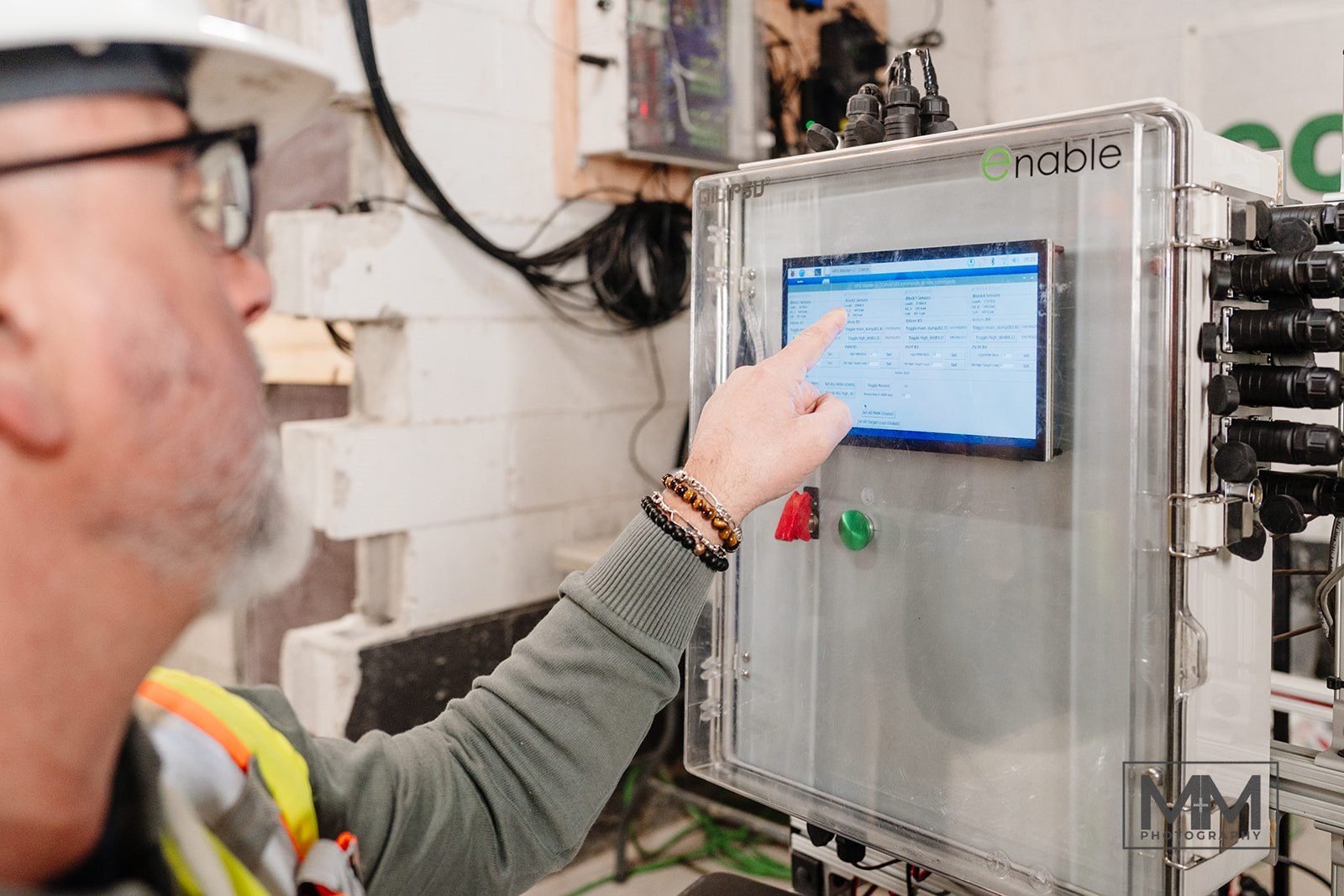

An engineer using the touchscreen on the Enable hydraulic control cabinet
The control cabinet
250 HeathLive data

The monitoring earned its keep.

An Enable-built data acquisition system read up to 50 sensors every second and pushed the data to the cloud: strain gauges on the concrete, the existing rebar and the new steel, load cells at each load point, displacement sensors, and temperature and humidity.

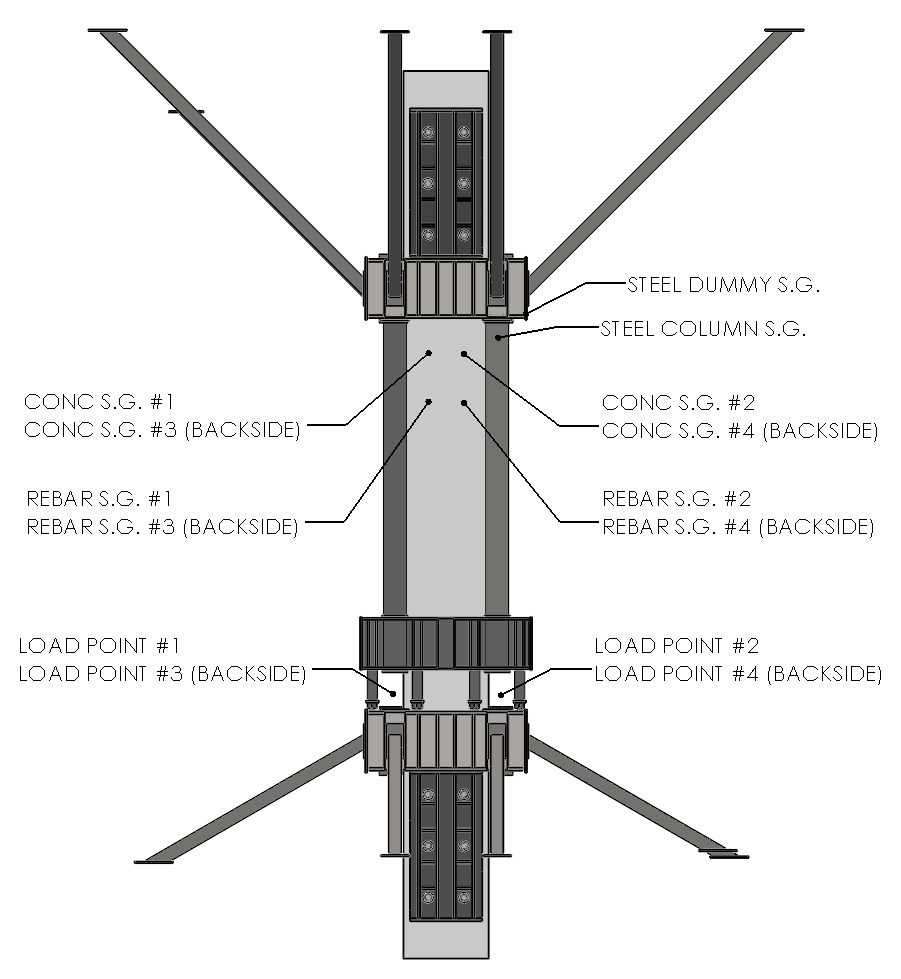

Elevation of the column and brackets labelling the steel, concrete and rebar strain gauges and load points 1 to 4
Sensor layout

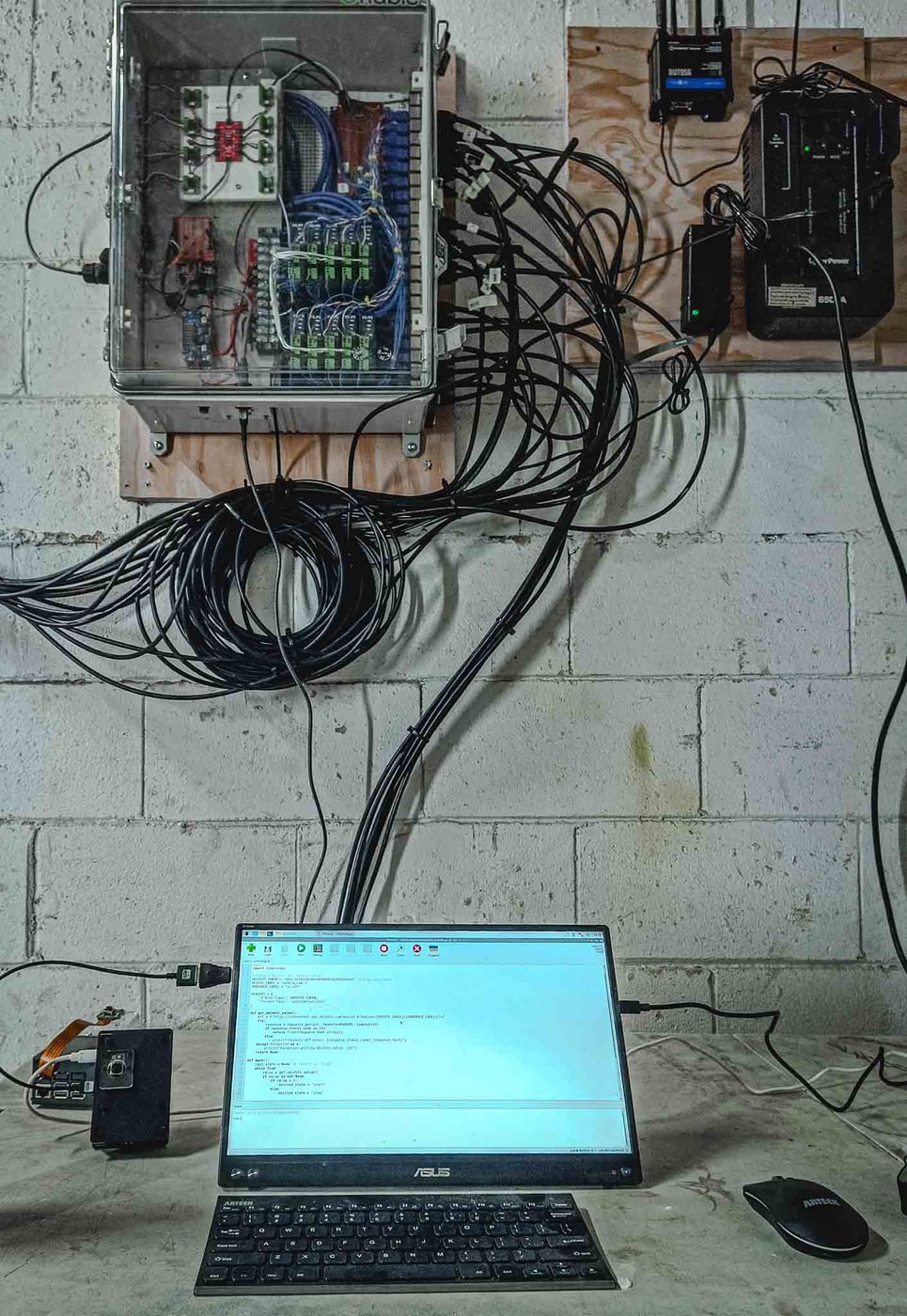

Data acquisition enclosure on a block wall with sensor cables running down to a laptop
Data acquisition on site

Partway through demolition, it caught something.

01 · DetectedThe column picked up an unbalanced moment.
02 · ExplainedChipping had disengaged slab framing into the column.
03 · AnalyzedFinite element analysis of the new condition.
04 · RebalancedHydraulic pressures adjusted across all four points.

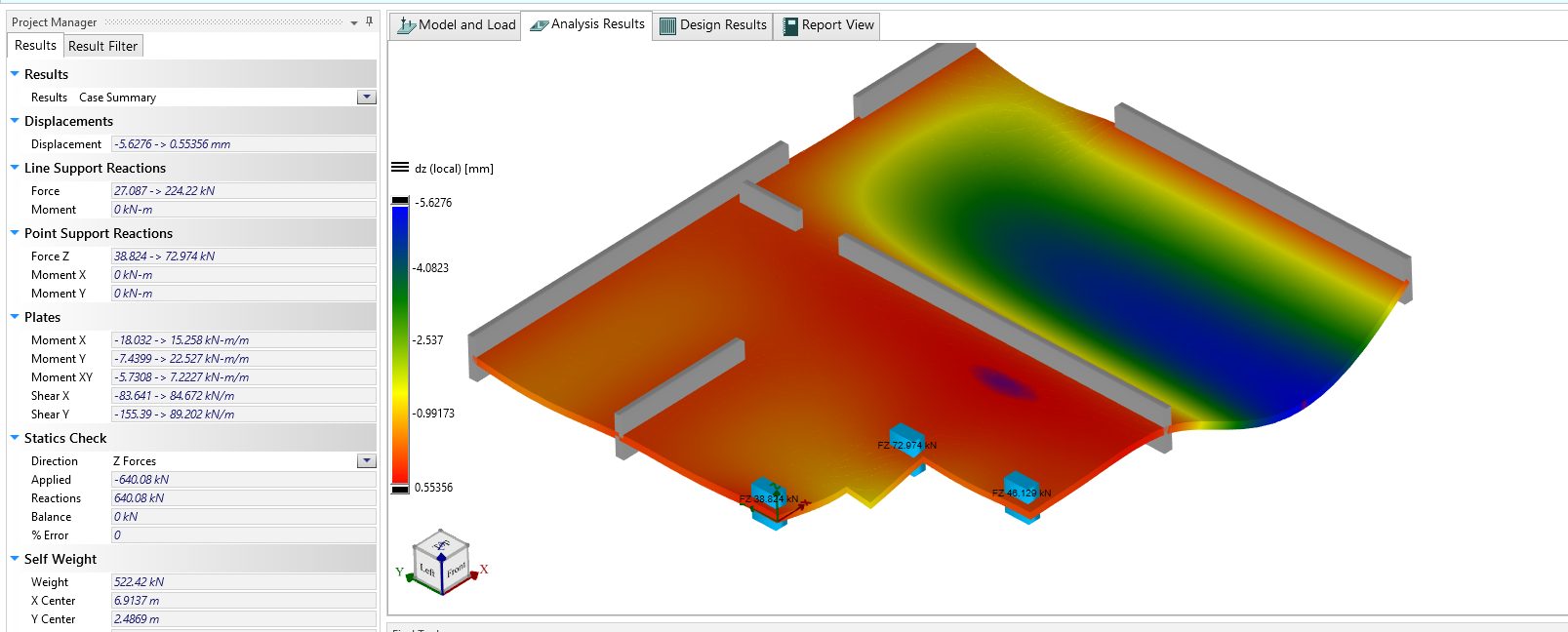

Finite element model of the slab framing into the column, with a colour contour of the results
Finite element analysis of the changed condition

We worked out what had happened before going any further, rebalanced the load and carried on. That's what second-by-second monitoring is for.

250 HeathThe repair

Welding steel that was never meant to be welded.

About 75% of the column was removed and replaced. Repairing the corroded bars meant field welding existing reinforcing steel that wasn't a weldable grade.

We developed our own procedure for it. Pulsed GMAW kept heat input down. Thermocouples mounted on the rebar confirmed preheat, and post-heat was held for four hours after each weld to drive hydrogen out of the steel.

~75% of the column replacedPulsed GMAWPreheat by thermocouple4 h post-heat, every weld

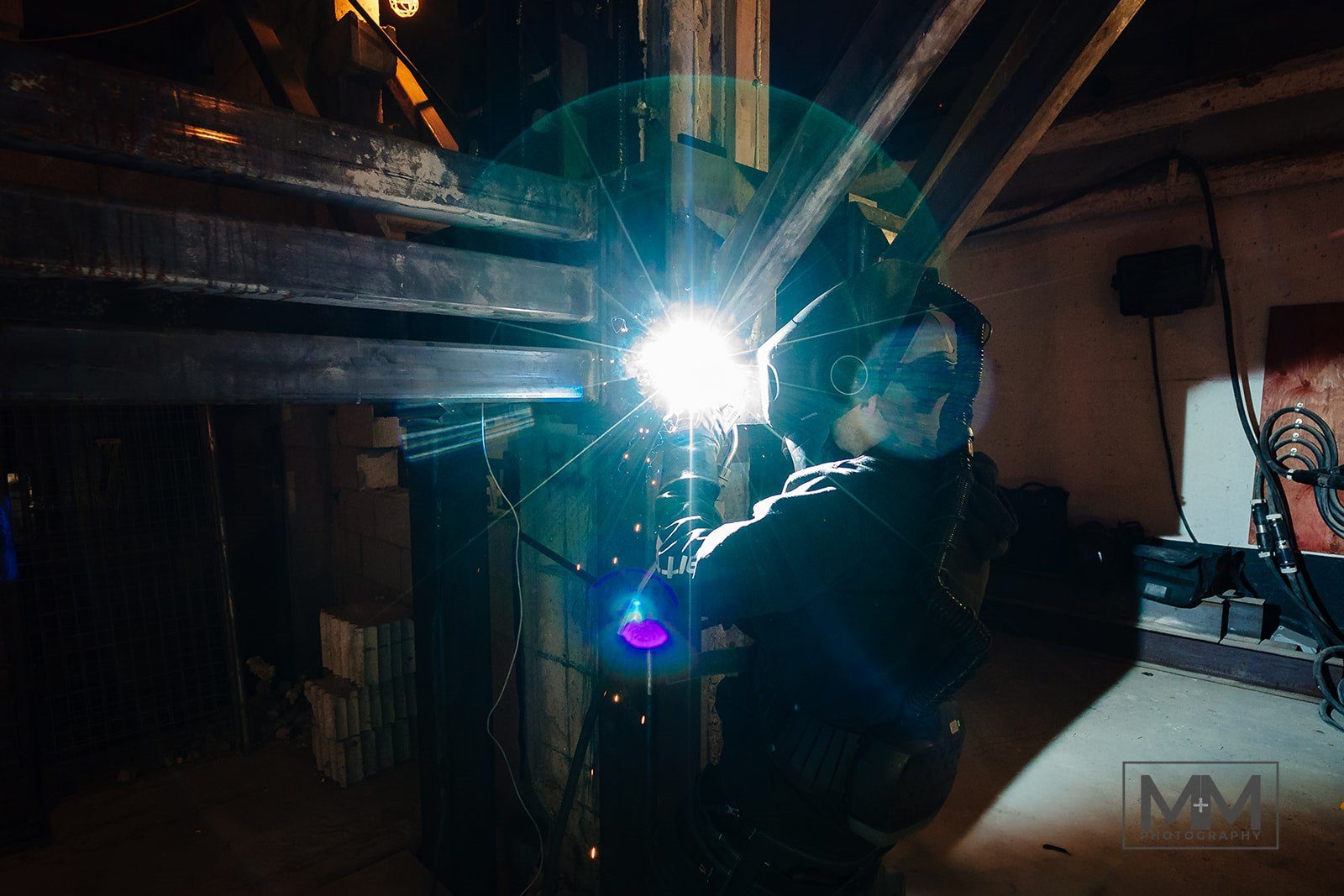

A welder working on reinforcing steel inside the steel bracket assembly, lit by the arc
Field welding existing reinforcing steel at P1
How we engineer welds like this →
Hand-backBoth towers

Load back on new concrete.

At Jackson, the load came off the steel and back onto the re-poured columns under live monitoring. At Heath, the strain gauges confirmed the new concrete is carrying the building.

That's the difference from a jacket. Both repairs restored the load path instead of covering the damage.

● Live · 250 Heath Street
We streamed the whole job. Live video and sensor data ran on a public dashboard so anyone in the industry could watch a new way to repair building columns, one load step at a time.

Fifty sensor channels, read every second. Each stage of the lift shows up as a clean step in the strain and position data.

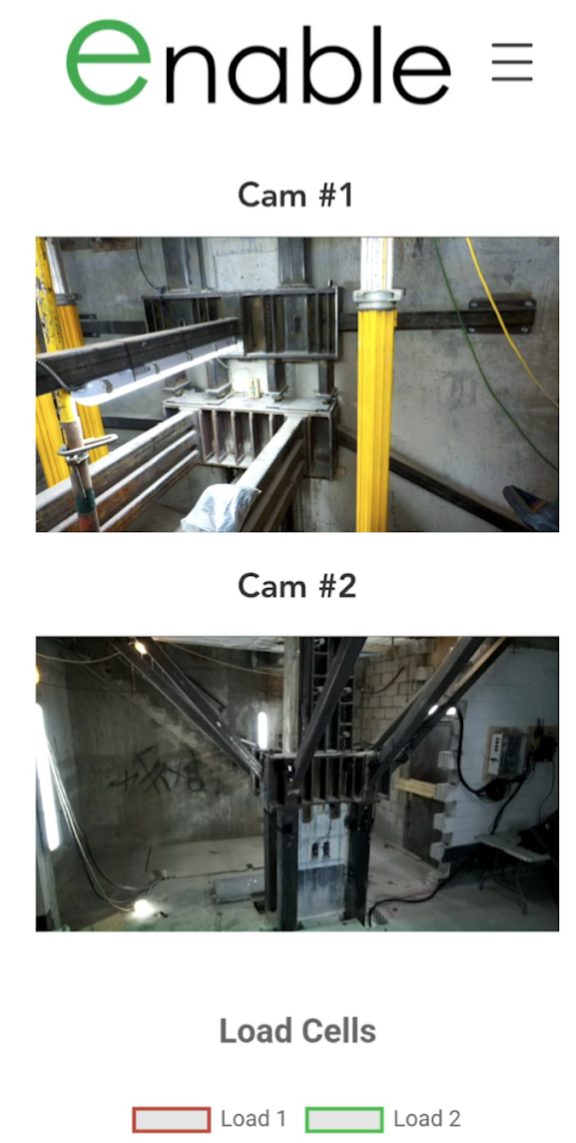

Mobile view of the public dashboard showing two live site cameras and a load cell chart
Live cameras on mobile

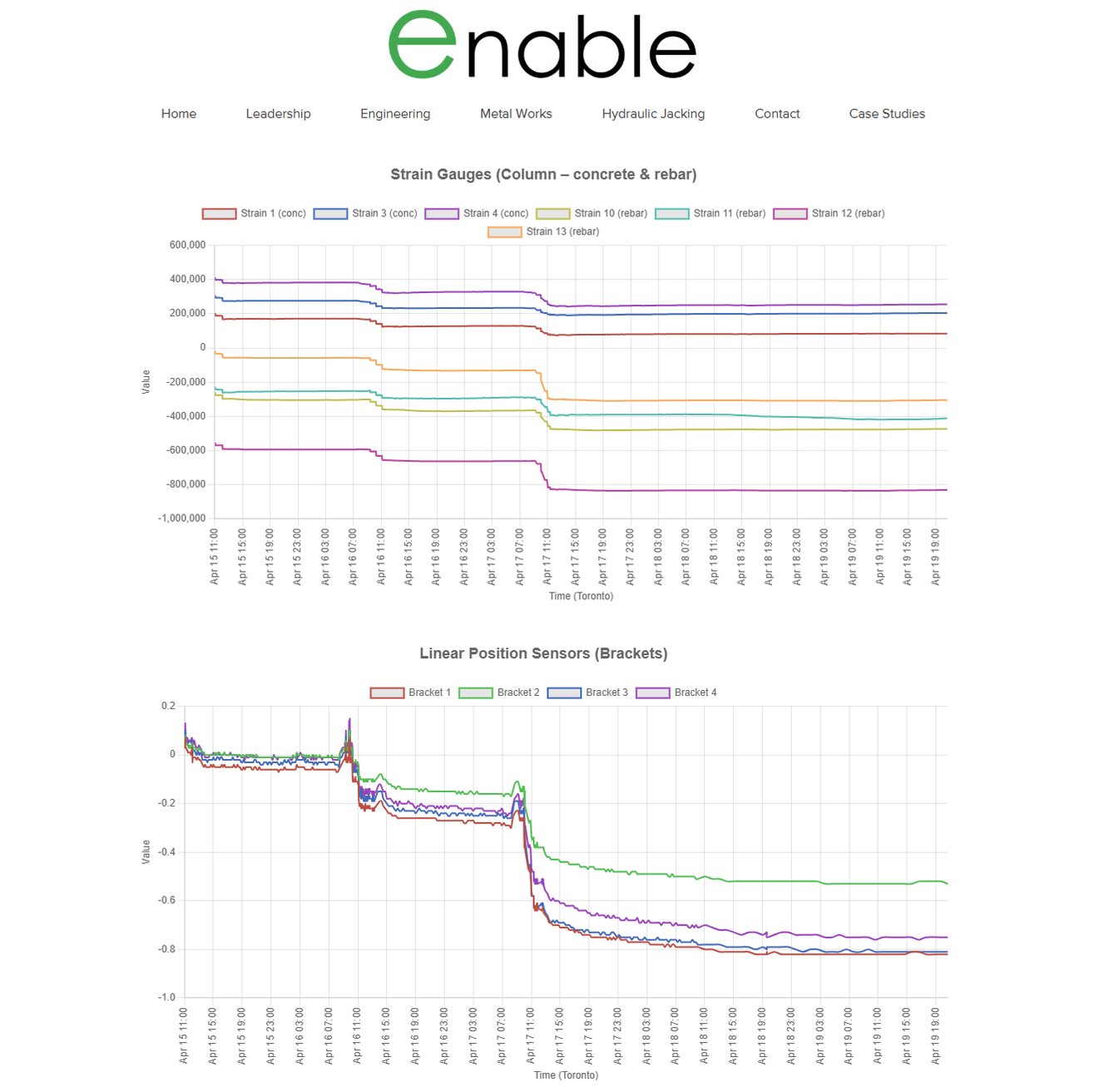

Enable public dashboard showing strain gauge readings and bracket position sensors stepping with each load stage
Strain and position, Apr 2025

Load returned. Residents stayed. Twice.

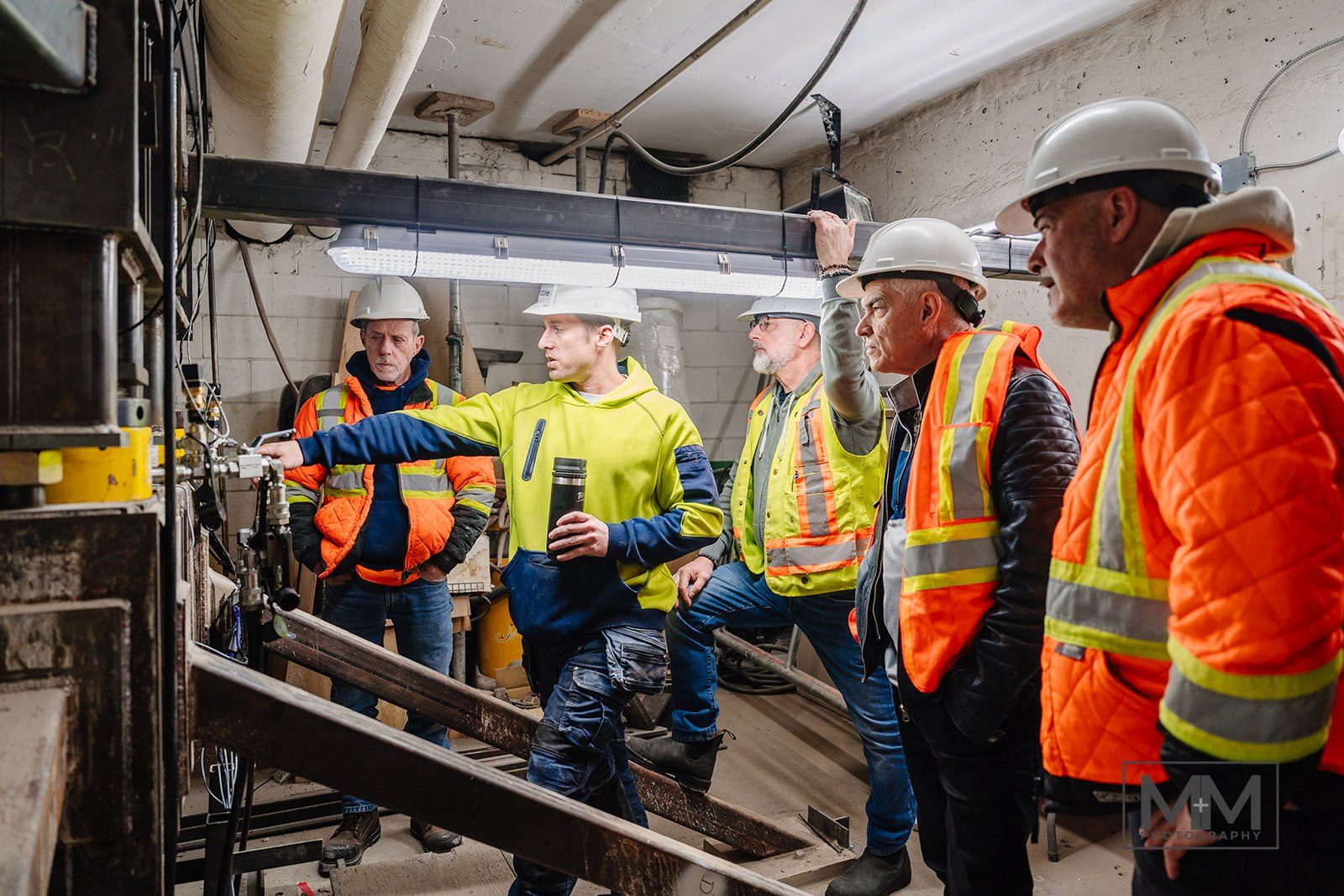

Engineers and contractors in hard hats gathered at the bracket assembly, one pointing at a load point
On site at 250 Heath Street during the lift
Load path restored New concrete carries the building in both towers. Strain gauges confirmed it at Heath.
Caught and corrected live An unexpected moment was detected by monitoring and rebalanced through the hydraulics.
Occupied throughout No staged shutdowns and no tenants displaced, at either building.
One team Designed, built, installed, operated and monitored by Enable.
